Construction Update as of October 25

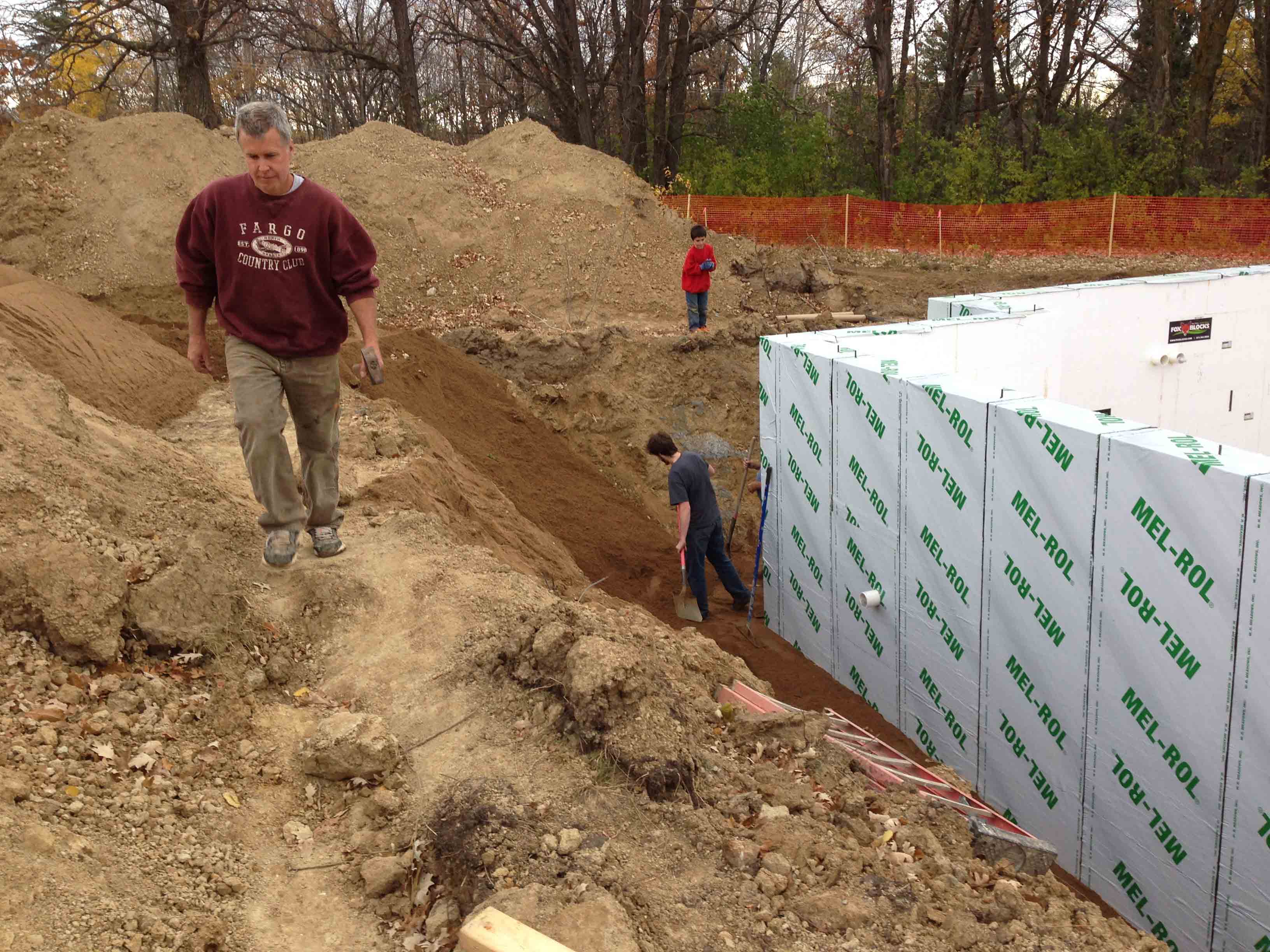

Here is Carl on Friday, the 17th, overseeing the backfilling around the
foundation. Since our site is mostly clay, the material right against the
building must be imported washed sand, for proper drainage. That's Aaron, Jerry
Peterson's young son helping out - seriously! - on MEA weekend, and Nolan, a
young man from Pine River, down in the excavation shoveling sand.

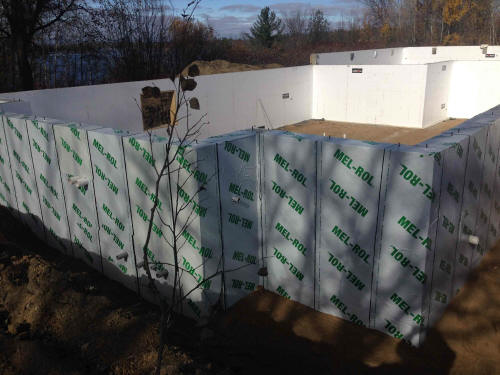

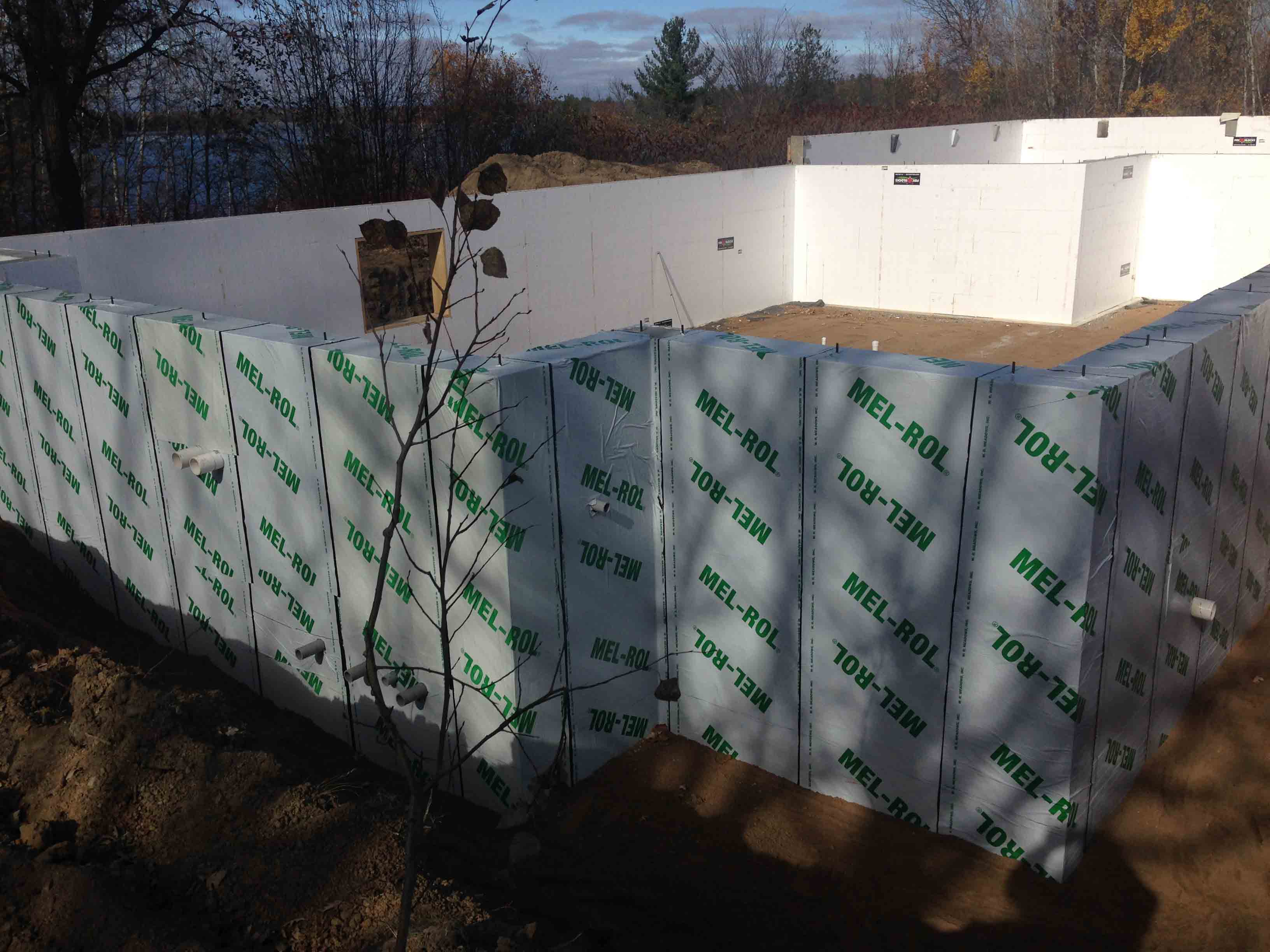

The foundation is now mostly covered with a Tyvex-like product called Mel Rol,
a 60 mil plastic and rubber fabric that waterproofs the foundation.

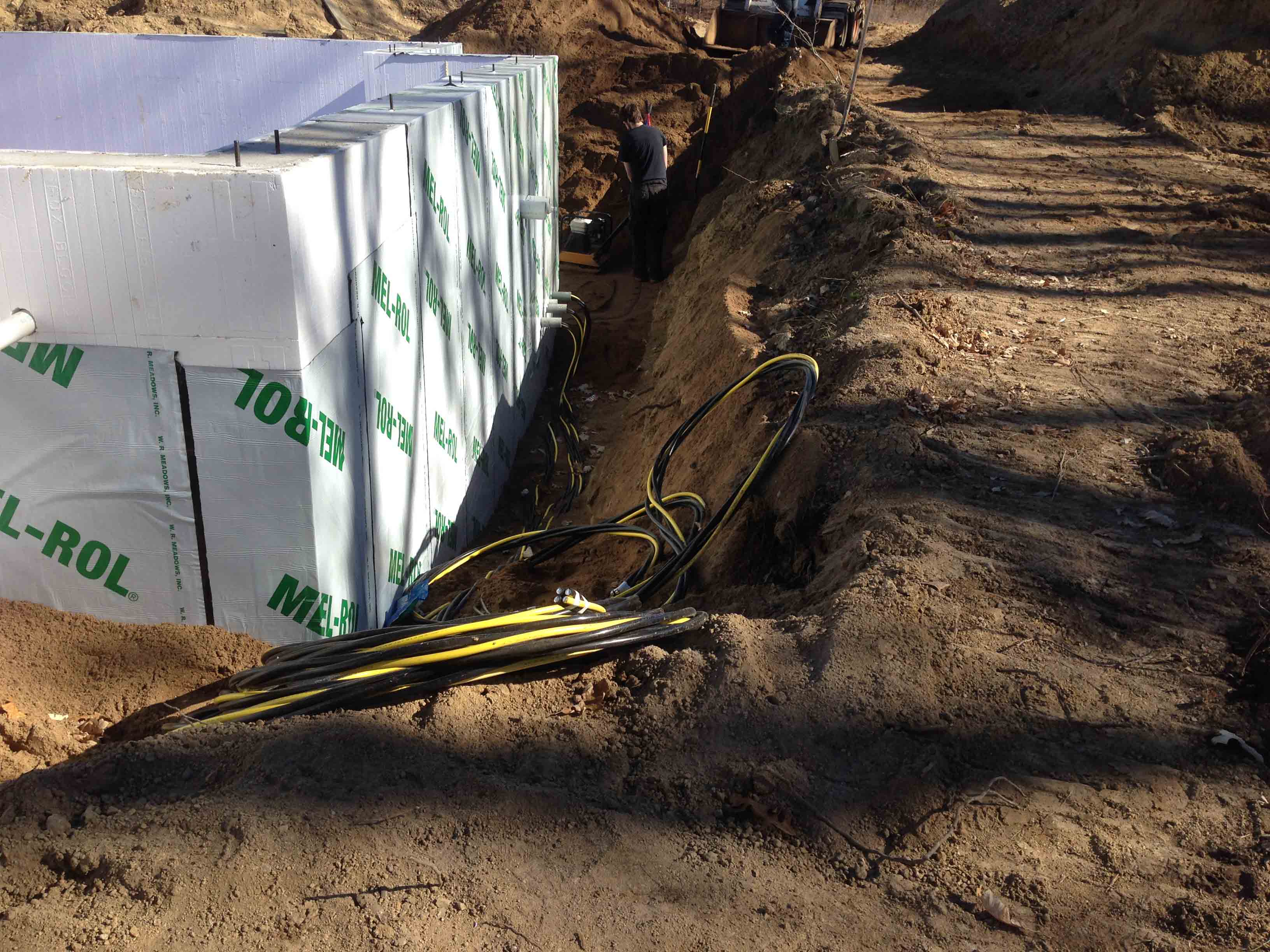

Kirk Lowe, our electrical sub-contractor, stopped by on Monday, the 20th, to
install the permanent electrical cable to which MN Power will connect in due
time.
By Monday, also, with the basement plumbing already in place, Carl and his

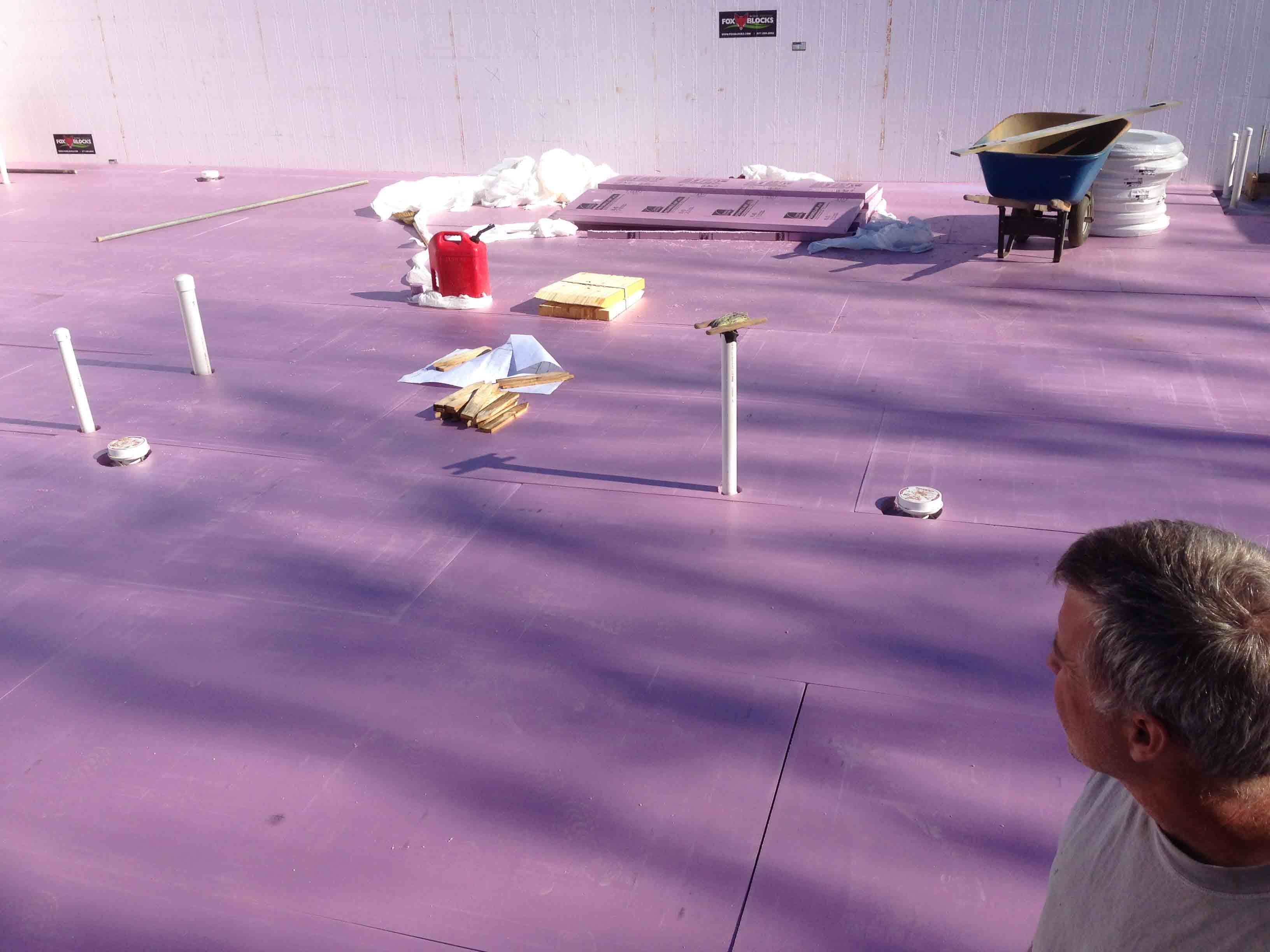

crew laid two-inch thick sheets of Styrofoam on the sand floor.

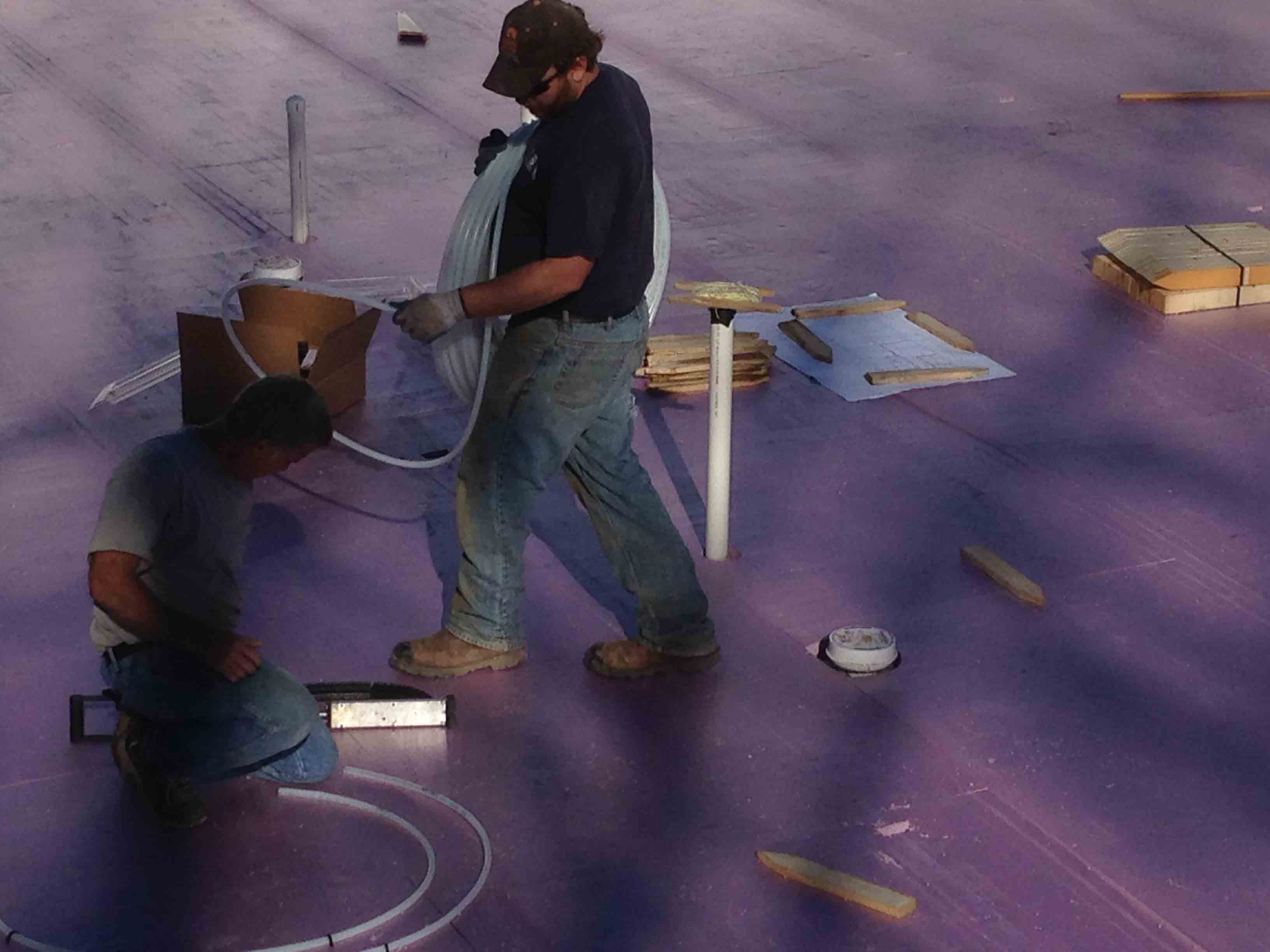

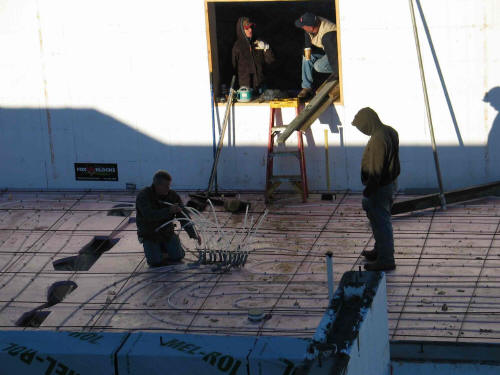

On top of the Styrofoam, Carl and Jason Snodgrass laid the piping that will
carry the in-floor heat for the basement.

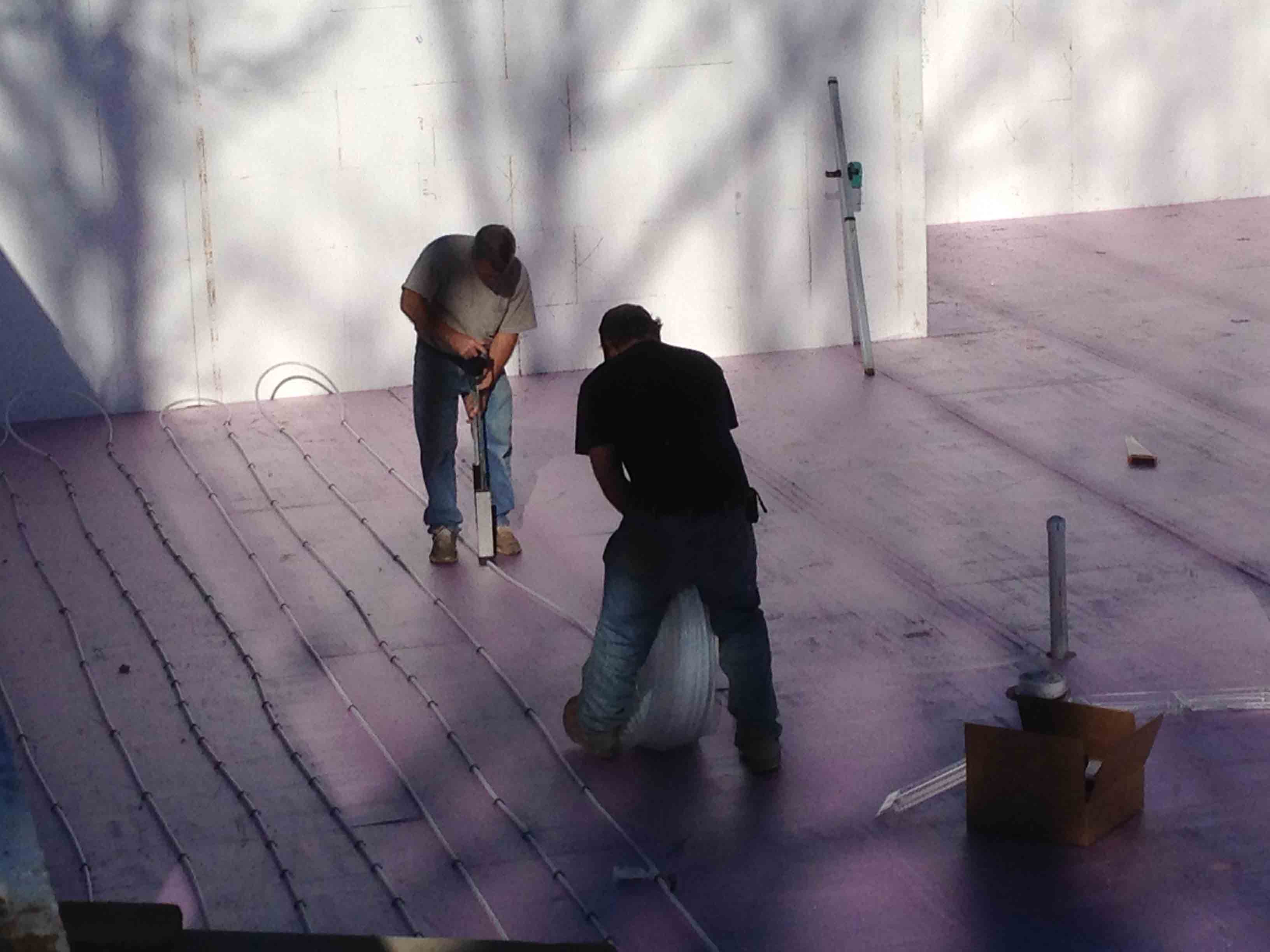

Here Carl uses a special stapler to fasten the pipe in place while Jason
unrolls and lays out the pipe.
8:30 AM. It's still dark on the lake side of the foundation; that's Shari
Peterson and Brad Edwards in the window consulting about preparations for the
pouring, while Carl and Jason tie up the loose ends of the in-floor heat piping
so that it won't be buried by the concrete when it comes at about 9:00 AM.

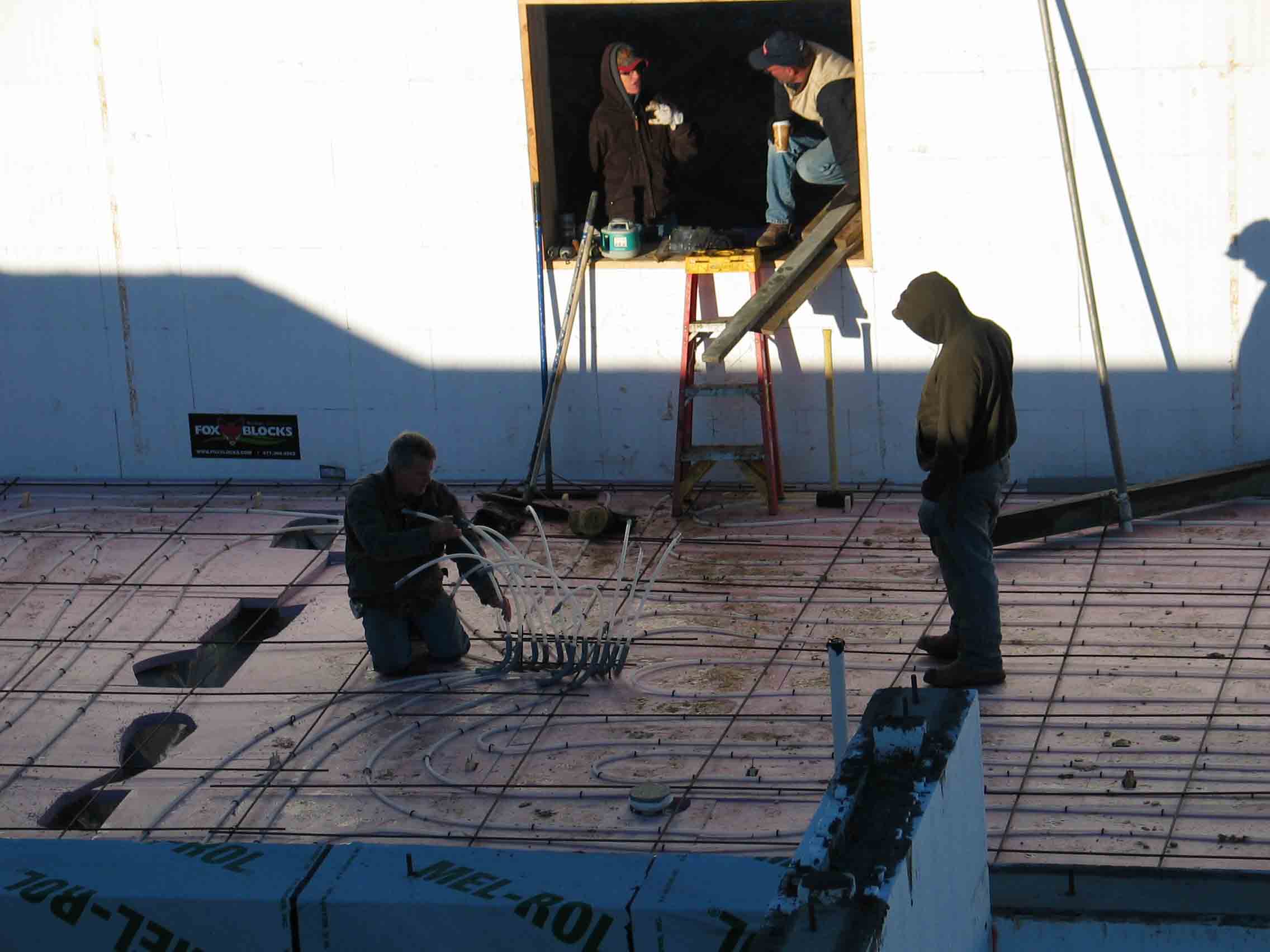

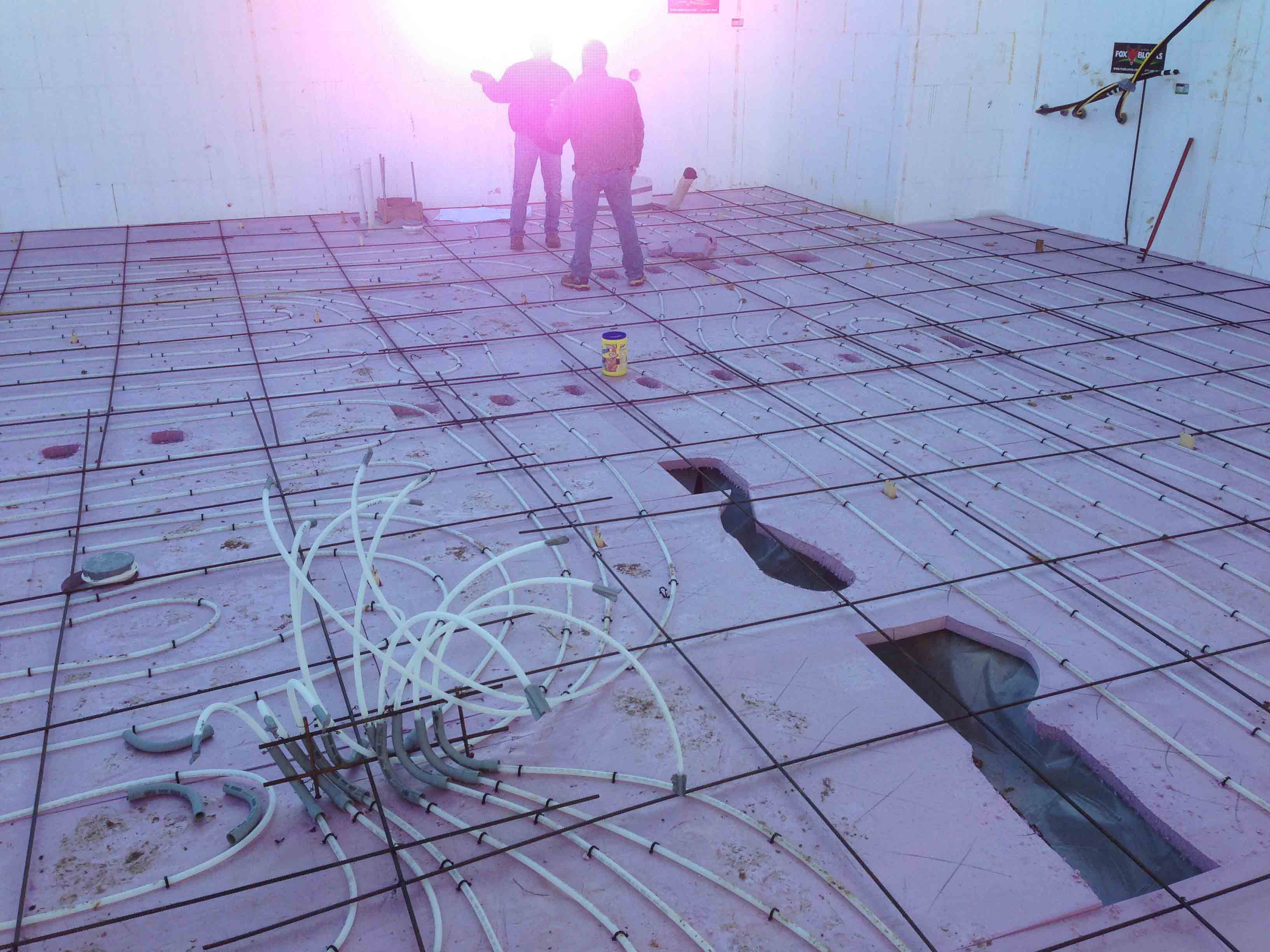

8:32 AM. The floor is ready with piping and rebar for the pour. Those holes
in the styrofoam will allow the floor concrete to pour down and settle on some
under-floor footings that will carry bearing walls.
On Tuesday, the 21st, at about 9:00 AM (the shadows reveal how low the sun

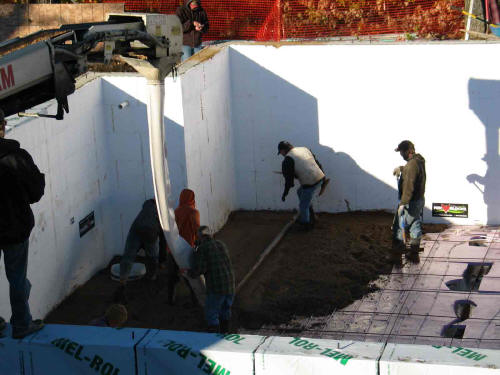

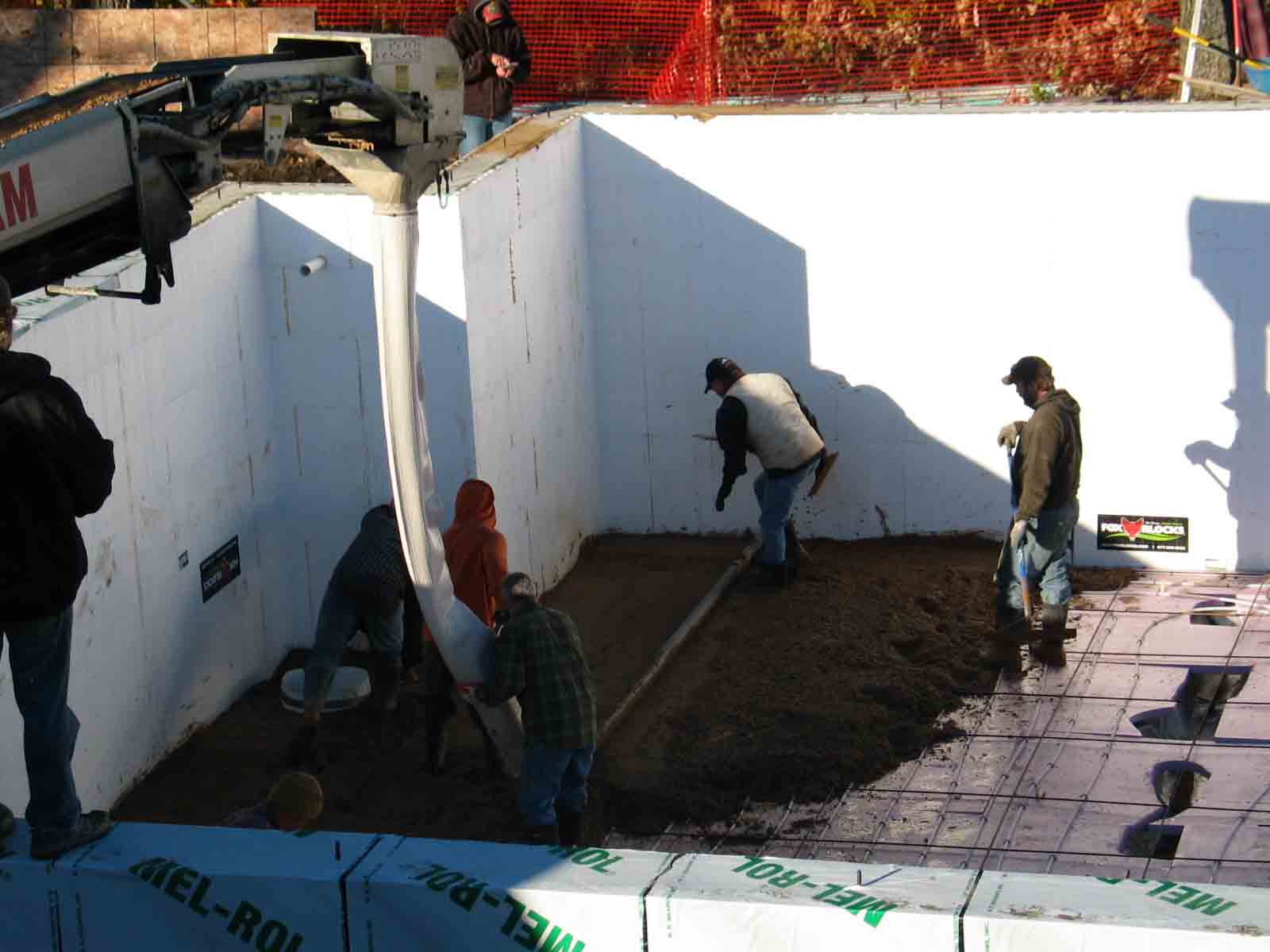

still is in the morning sky) the pour began in the southwest corner of the
basement. Here the crew uses shovels and a screed to level the concrete as it
pours from the conveyor on the BMI truck.

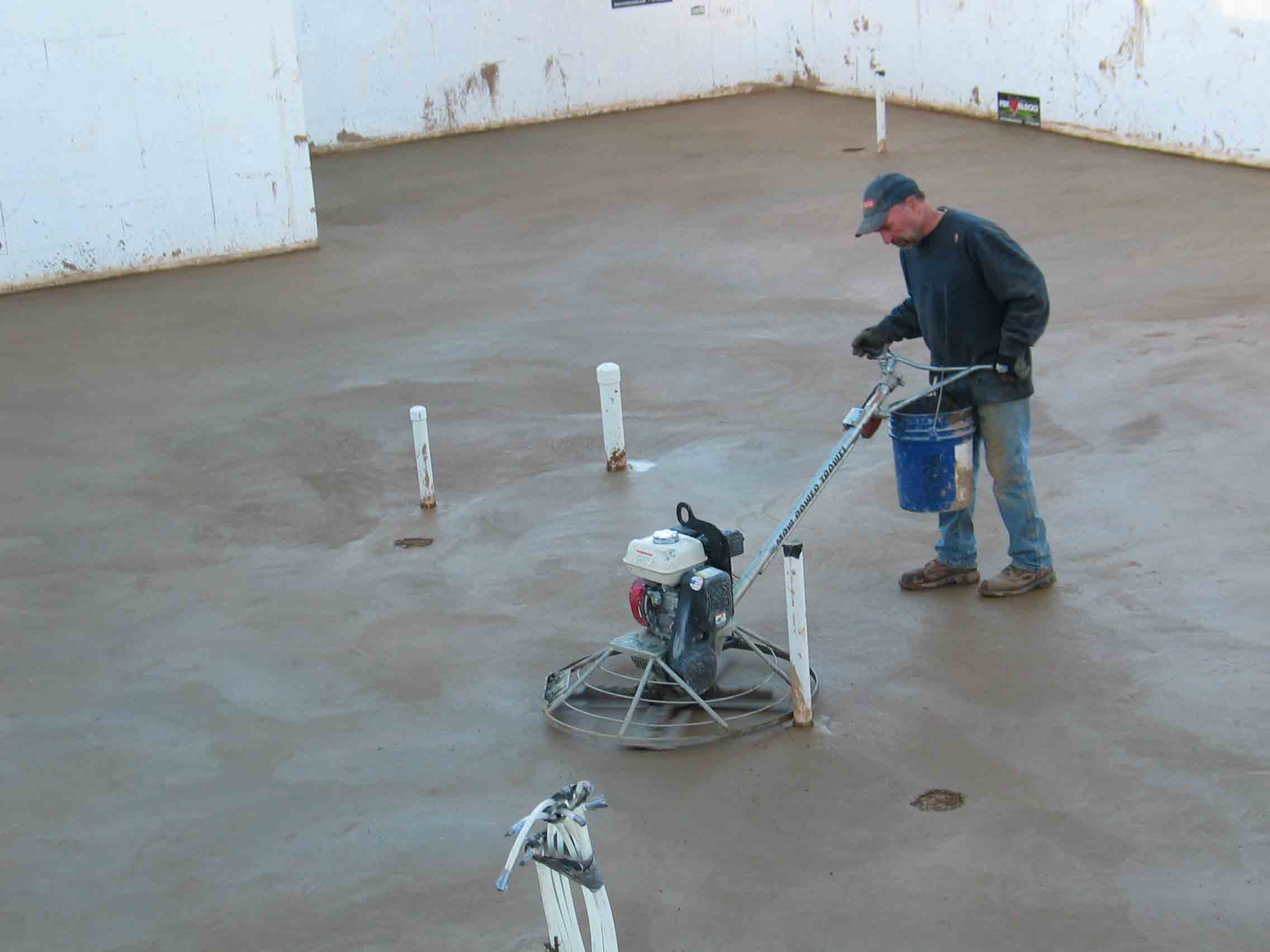

Late that afternoon, at about 5:00 o'clock, Brad Edwards is power trowelling
the surface of the new floor to make it perfectly smooth.

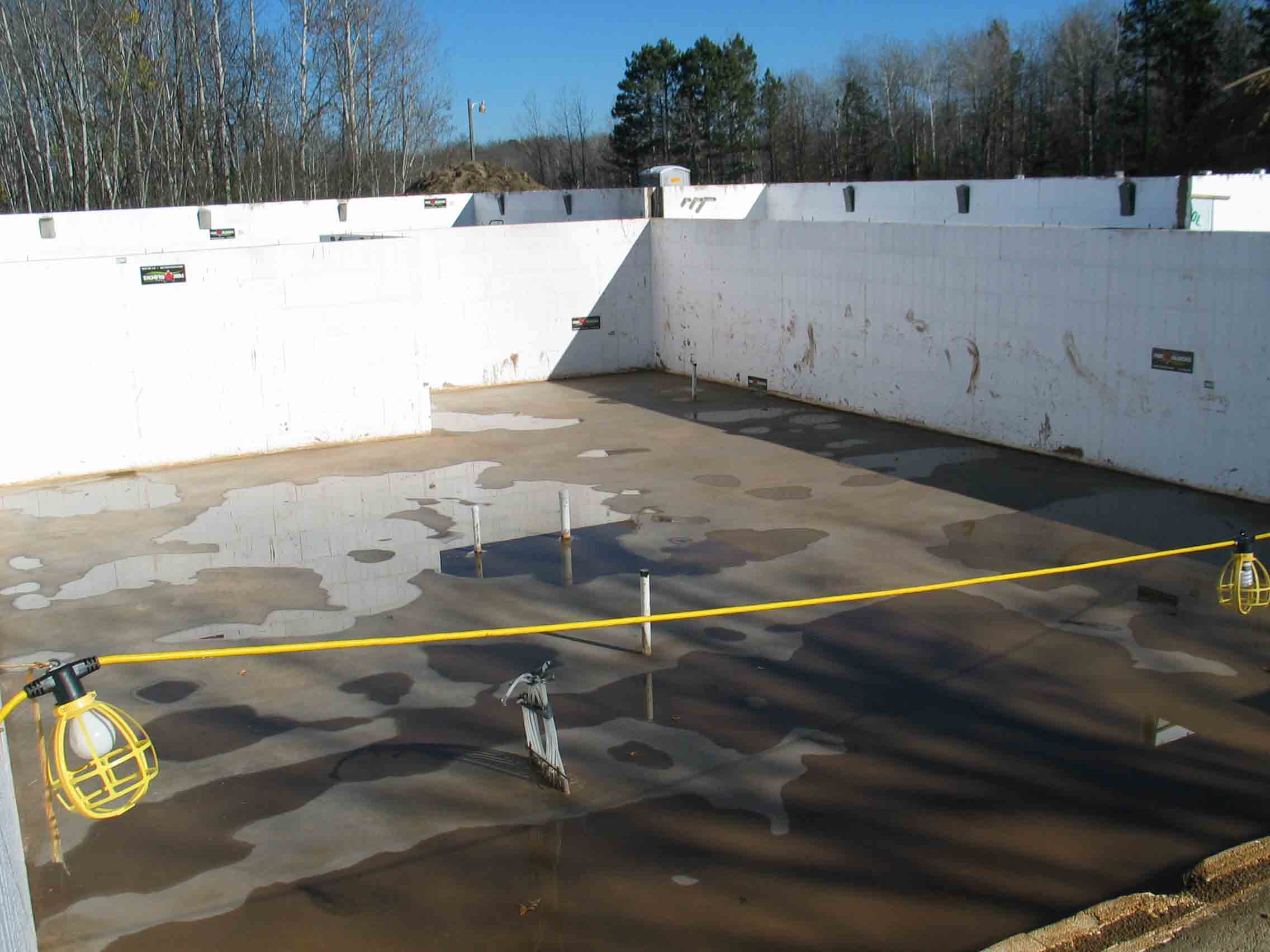

Tuesday evening, we had a little rain, and the next morning there was rain
water on the floor - not a problem, as it slowed down the setting process and
helped make for strong concrete. But Shari and a colleague would come with leaf
blowers later in the week to dry up the water and clean the floor to prepare the
concrete for sealing.

Meanwhile, two of our six new 3,000 gallon septic tanks had been delivered
and unloaded in the south parking lot.

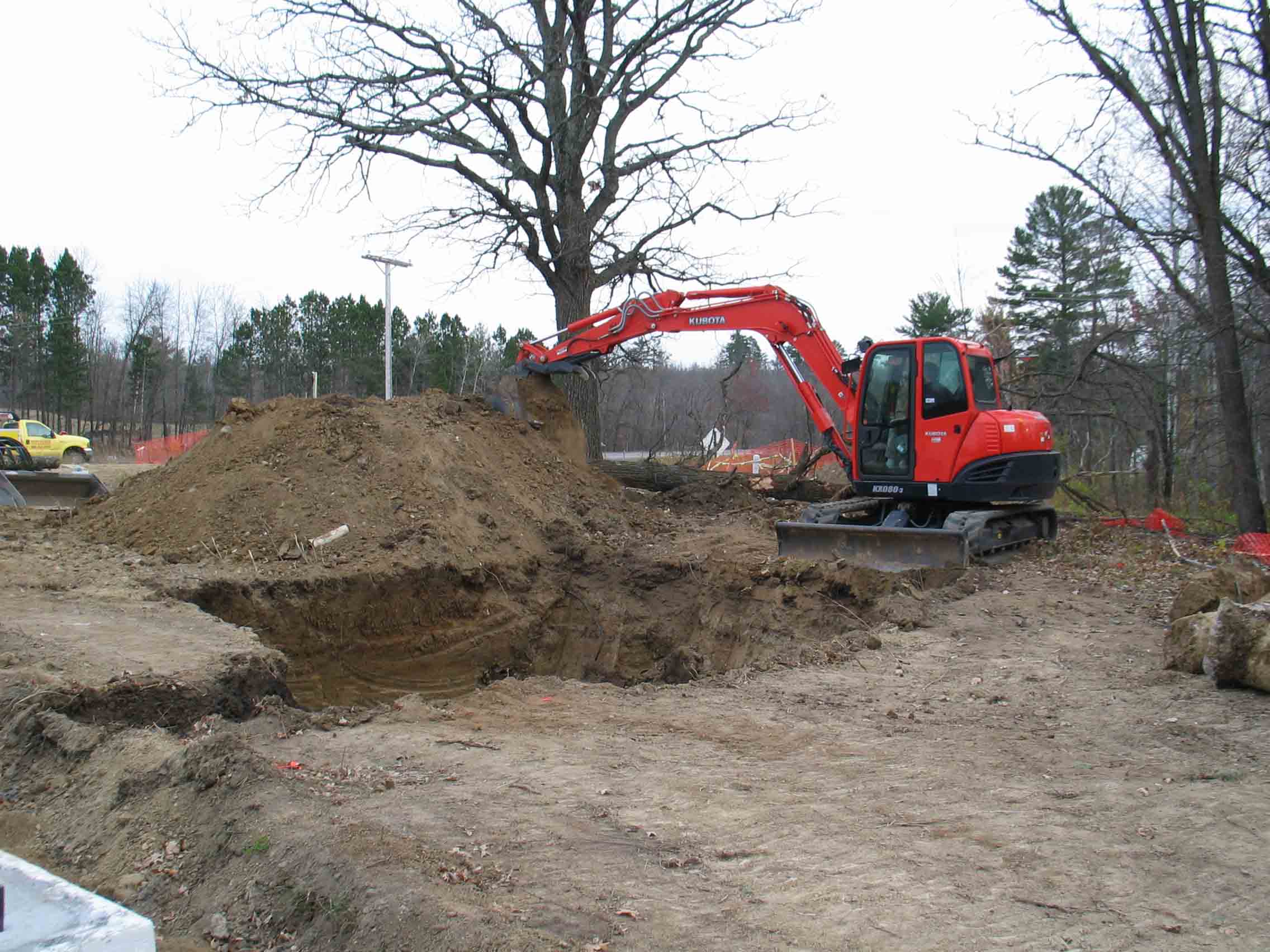

Here is Rick Smith on Wednesday, the 22nd, excavating for the septic tanks.
There will be six altogether, in two rows of three each. One will be a grease
trap. The "high strength" waste will have ample time and space to settle out
before flowing down to the south parking lot, where it will receive additional
treatment and "polishing" before being pumped under Highway 371 and up to the
new drain field on the east side of the highway.
Meanwhile, the new drainfield - actually four new mounds, each with its own
pump, is complete. Hundreds of dump truck loads of sand, sandy loam and black
dirt have been hauled up and carefully contoured to provide for proper dispersal

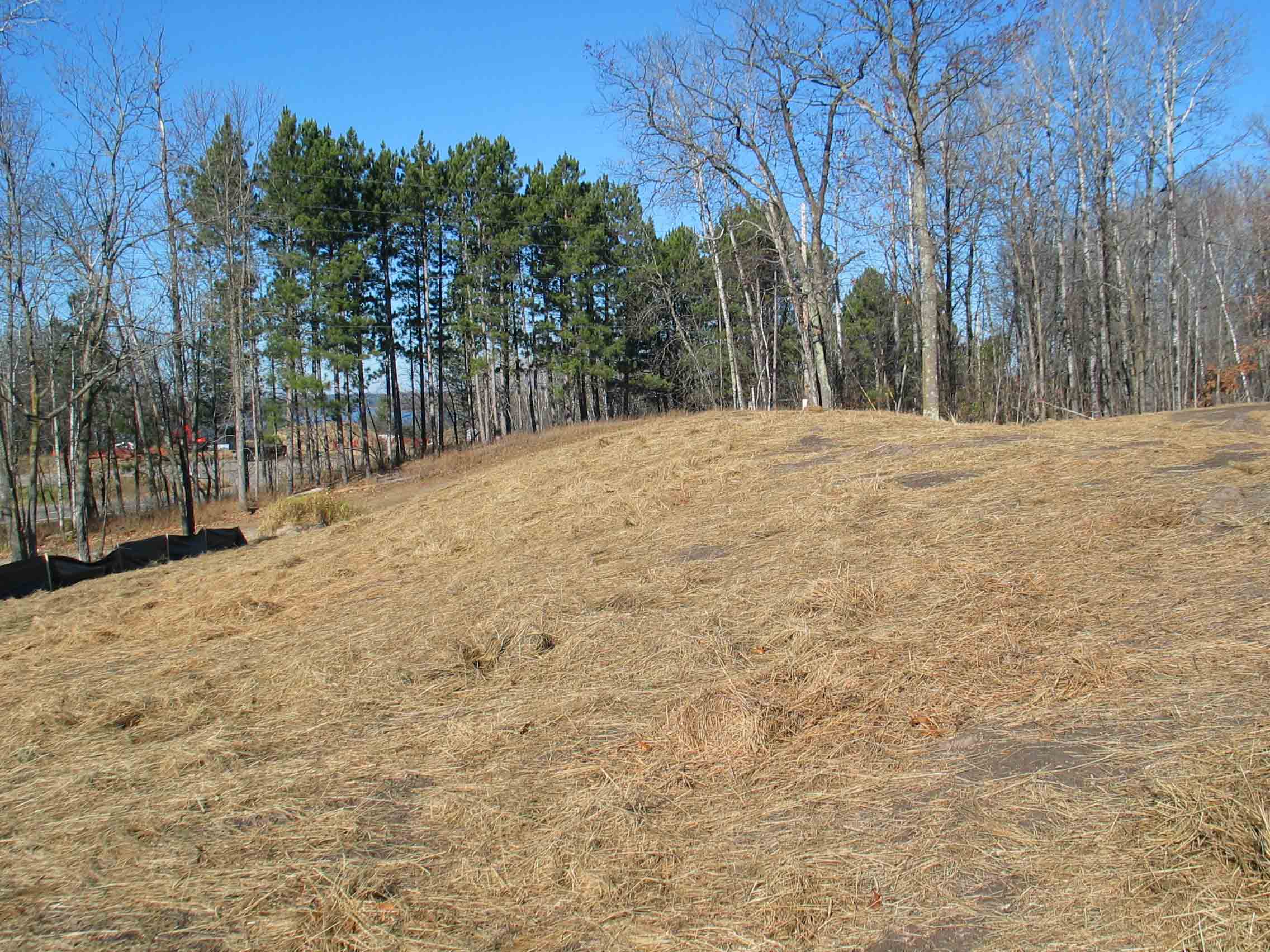

of the effluent. Here you see the drain field seeded and covered with straw to
prevent erosion and retain moisture for the seed.
Already, curiosity-seekers have been seen driving up into the drain field
area. So on Thursday I rigged up this menacing sign to ward them off. Driving
SUVs or snowmobiles on the drain field would cause major damage to this
expensive installation.

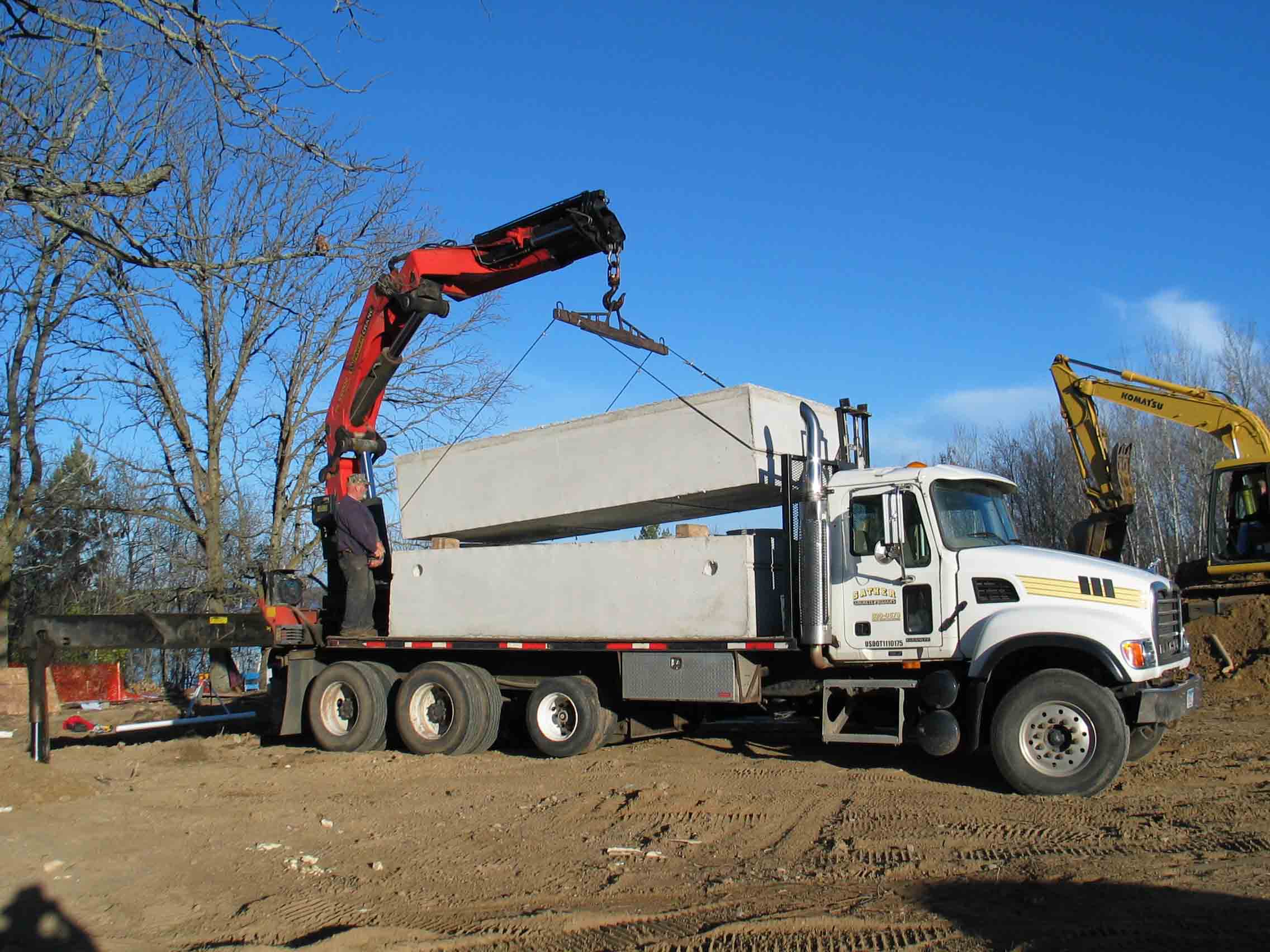

Rick Smith set the septic tanks yesterday. Here is the first one being lifted
off of its truck. The tanks come in two parts, which are sealed with a heavy
rubber-like compound that is applied to the top rim of the bottom half of the
tank before the top half is lowered on to it. Each tank weighs about 20,000
pounds, or ten tons!
And while the tanks were being set, Ed Swanson, Greg Anderson and Larry
Overcash were hauling the fill from the foundation excavation off of the site
and over to our property on the east side of 371 where they disposed of it at
the south end of our property. As soon as that task is complete, I'll seed the

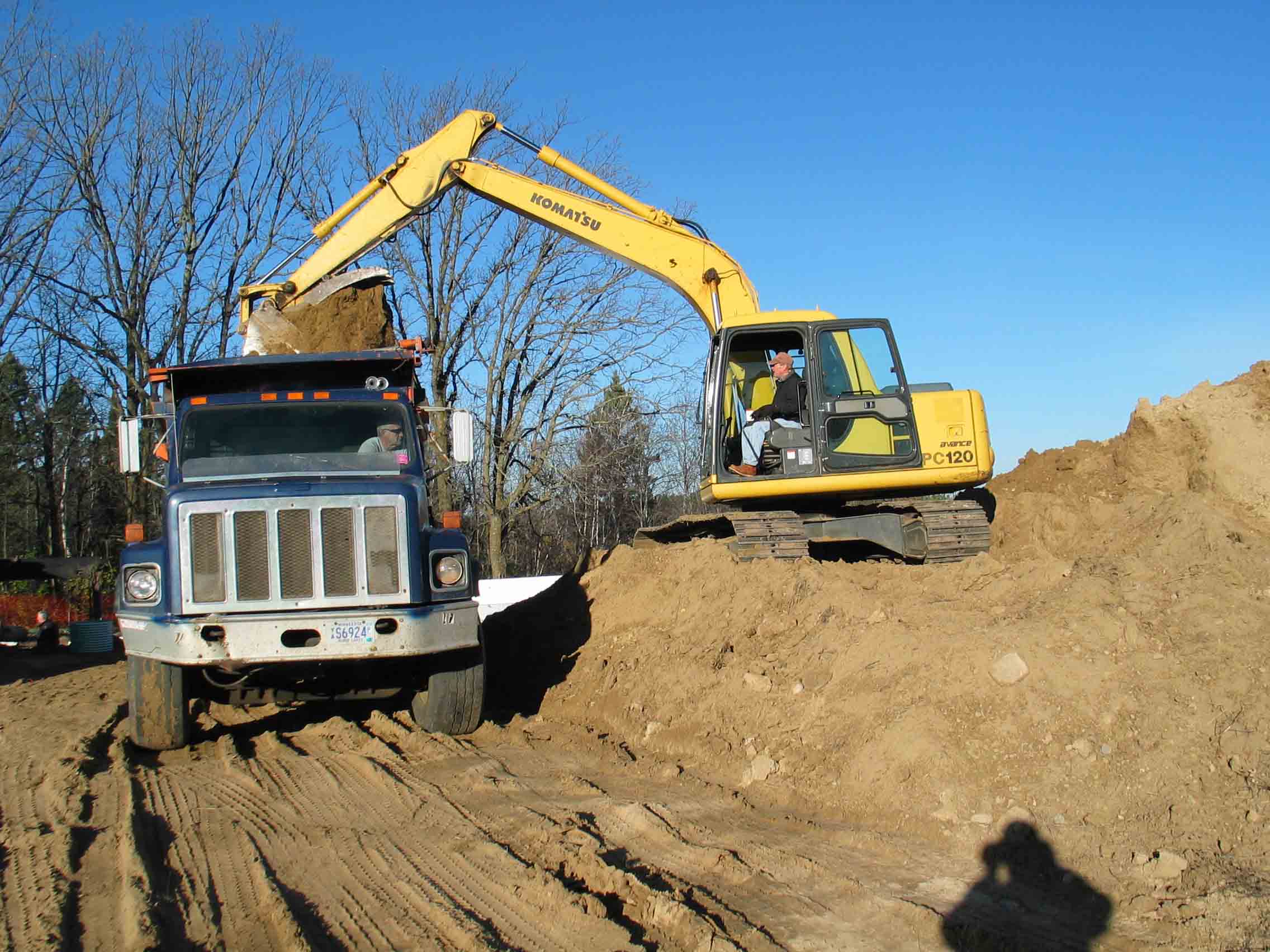

area to prevent erosion. That's Ed Swanson driving the backhoe, and Greg
Anderson at the wheel of his dump truck.

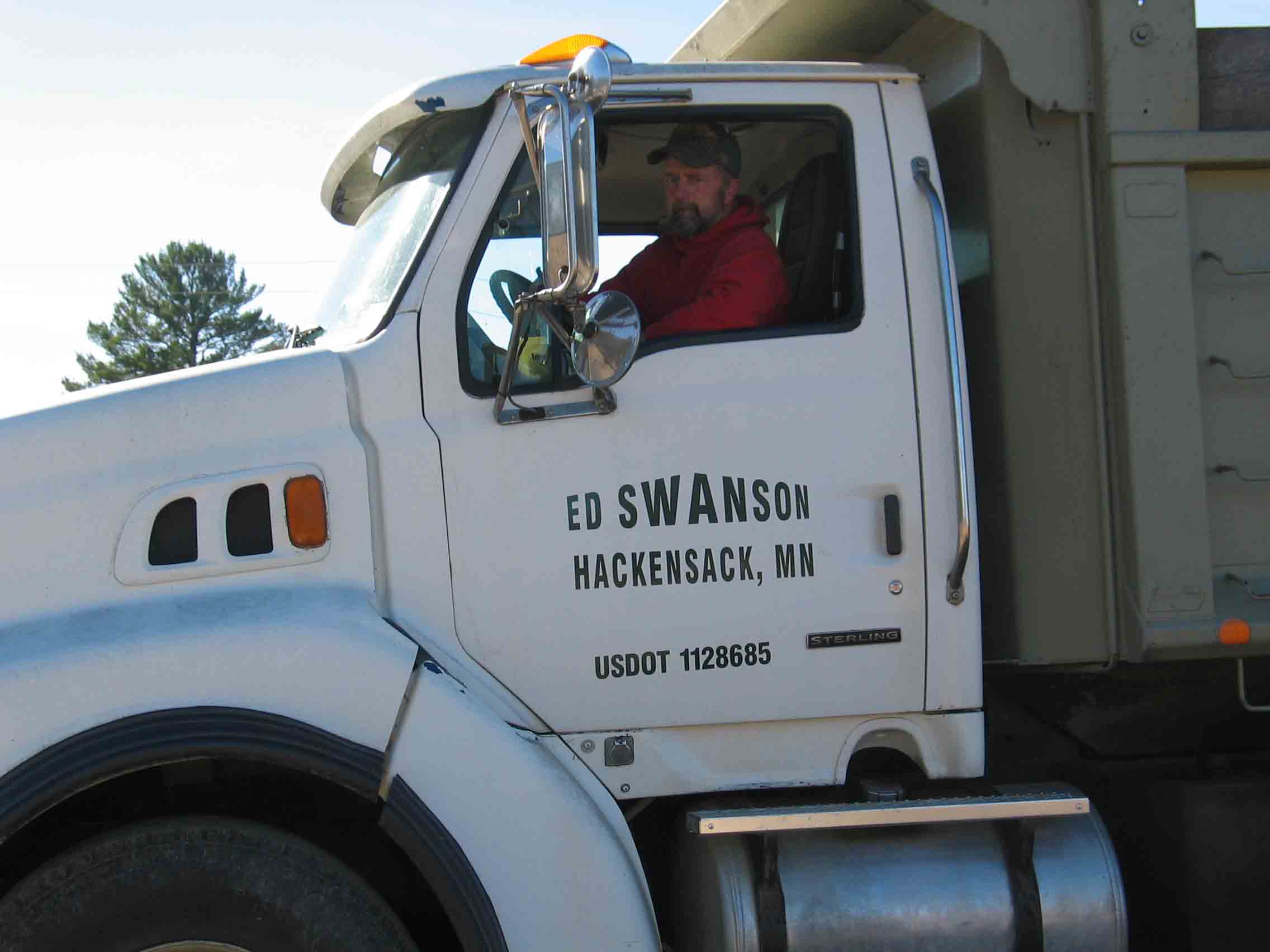

And here is Larry Overcash, waiting for his truck to be refilled.
About 8:45 yesterday morning Rick, Jack and Vern were preparing the spot
where the bottom of the first tank will be set.

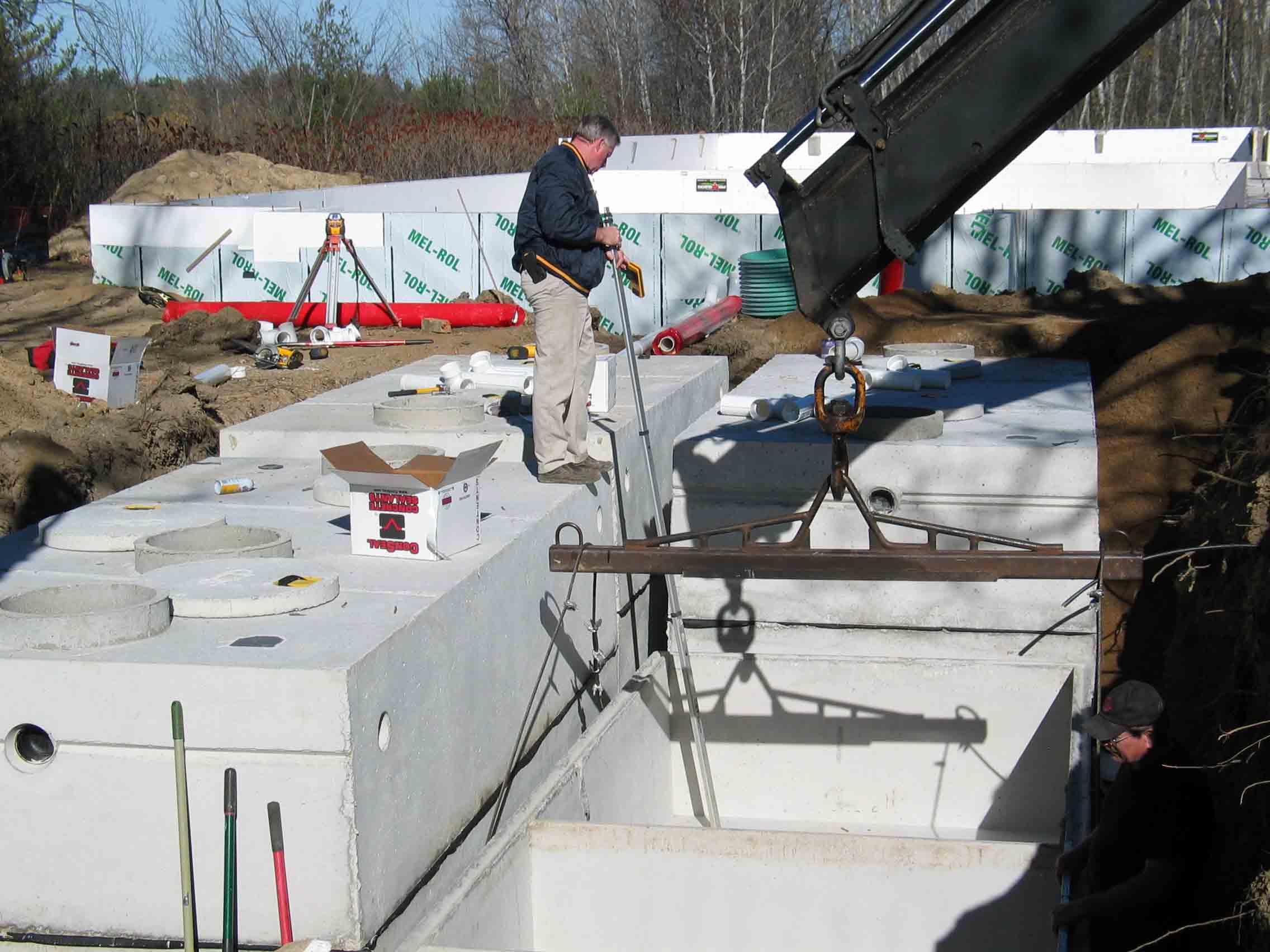

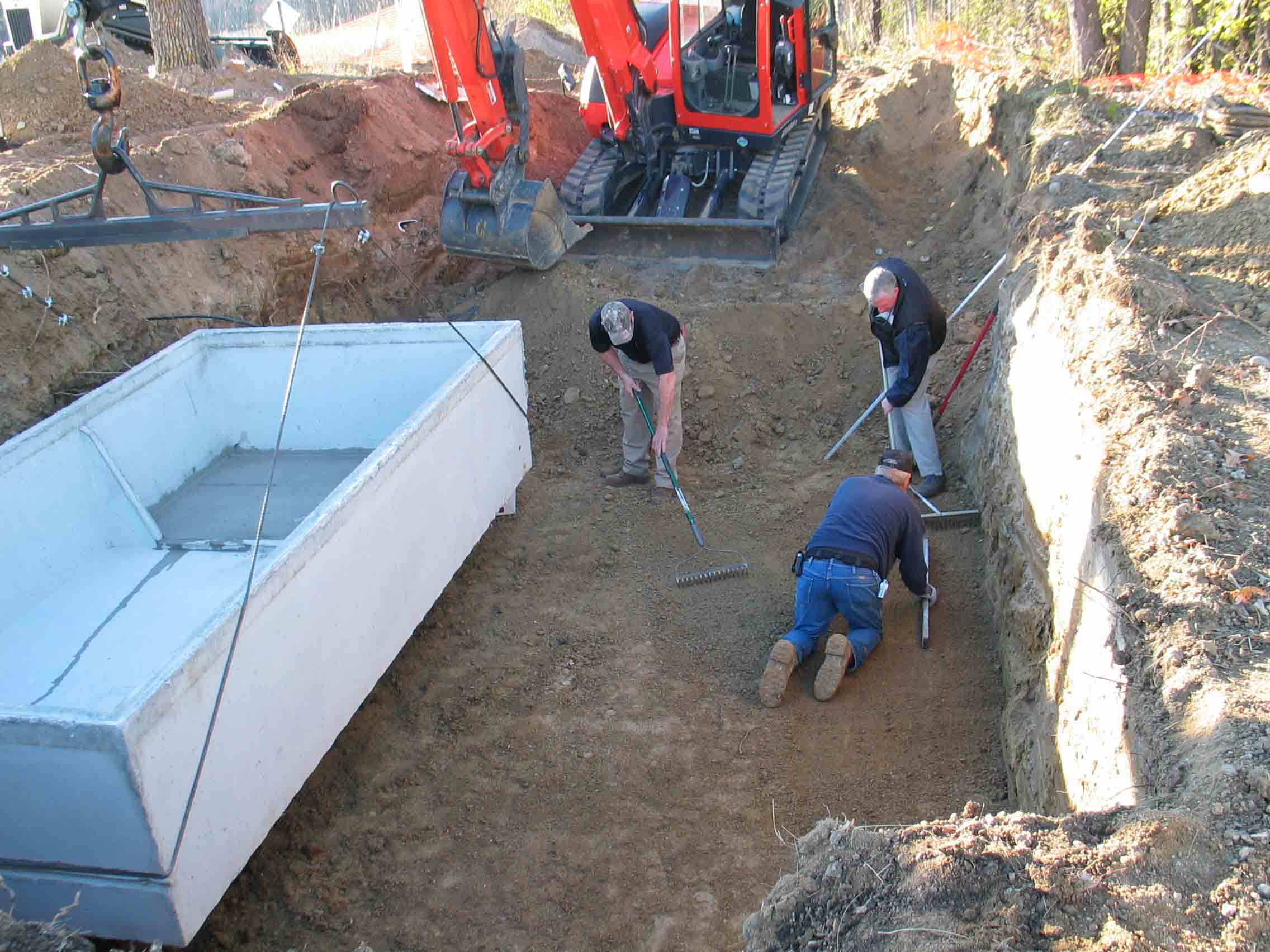

By about noon yesterday, Rick and his crew were lowering the bottom half of
tank No. 4 into position.
Next on the agenda: setting the floor joists in the building. Their delivery
is about a week overdue.
